A Guide to the Solar Panel Installation Process

PES Supply, a PES Global Group Company
· 19 min read Reviewed by PES Supply editorial team
Installers mounting solar panels onto rooftop racking during a residential install

Table of Contents

    For installers, EPCs, and developers, a successful solar project is more than just bolting panels to a roof—it's a high-stakes process where timelines, budgets, and compliance determine profitability. From the first site assessment to the final Permission to Operate (PTO), every step is a critical milestone. A mistake in permitting, a delay in procurement, or a failed inspection can derail a project, inflate costs, and damage your reputation.

    This guide provides an actionable, field-proven framework for navigating the entire solar panel installation process. We'll break down each phase, highlighting the critical decision points, common pitfalls, and compliance watchouts to help you execute projects efficiently and profitably. The real-world outcome is a repeatable process that minimizes risk and maximizes your return on every job.



    Understanding the Full Project Lifecycle



    A team of solar panel installers working on a residential rooftop, showcasing the installation process.



    Before a single panel gets unboxed, every solar project follows a well-defined path. This isn't just a sequence of tasks; it's an integrated lifecycle where design decisions impact procurement, and procurement timelines dictate installation schedules. Understanding this full journey is key to managing cash flow, crews, and client expectations.

    Whether you're an installer managing residential crews, an EPC coordinating a multi-megawatt commercial build, or a developer modeling project ROI, the core stages are the same. Mastering the handoffs between these stages is what separates top-tier operators from the competition.


    Key Milestones in the Installation Journey



    The entire process breaks down into several distinct phases. A failure in one creates a domino effect of costly delays, change orders, and failed inspections.

    Here’s a real-world look at the path from contract to commissioning:



    • Initial Site Assessment: A forensic analysis of the building's structural health, the capacity of the existing electrical service (per NEC standards), and a precise shading analysis. This is where you identify project-killing surprises early.
    • System Design & Equipment Selection: Engineering a code-compliant, high-performance system. This involves selecting modules, sizing inverters from brands like Sungrow or Fronius, and integrating energy storage from leaders like FranklinWH or BYD.
    • Permitting and Interconnection: The administrative battle. Submitting flawless plan sets to the local Authority Having Jurisdiction (AHJ) and securing the interconnection agreement from the utility. This is the most common bottleneck for any project.
    • Procurement and Logistics: Sourcing all equipment—from panels and racking down to the last fastener—and ensuring just-in-time delivery to the job site. This is a massive logistical challenge driven by supply chain realities.
    • On-Site Installation: The "boots on the roof" execution phase. This covers the mechanical mounting of racking and panels, plus the complex electrical wiring that must adhere strictly to the National Electrical Code (NEC).
    • Inspection and Commissioning: The final hurdle. Passing rigorous AHJ and utility inspections to ensure the system is safe and code-compliant, followed by the systematic process of energizing the system and verifying its performance before grid connection.



    Critical Insight for Installers & EPCs: The most profitable contractors view the project as a single, continuous lifecycle, not a series of disconnected tasks. Mastering the handoffs between design, procurement, and field crews is where you protect your margins. At PES Supply, we streamline this with in-stock inventory and bundled freight, turning your logistical challenges into a competitive advantage.


    Mastering Site Assessment and System Design



    A solar panel installer taking measurements on a roof to design a solar energy system.



    A solar project’s success is determined long before the first truck rolls. It’s in the foundational work—the site assessment and system design—where projects are de-risked and profitability is locked in. This phase is about eliminating guesswork and heading off costly disasters before they happen.

    A professional site assessment is a forensic investigation, not a quick roof measurement. You are evaluating the roof's structural integrity, assessing the remaining life of the roofing material, and verifying the existing electrical service capacity. Uncovering an undersized main panel or a roof nearing its end-of-life during the initial visit prevents expensive change orders and client disputes later.

    A precise shading analysis is absolutely non-negotiable. Using professional tools to map the sun’s path throughout the year provides the hard data needed for accurate production estimates—the same estimates that secure financing and underpin performance guarantees.

    Translating Site Data Into a Viable System Design



    With solid site data, you can engineer a system that performs in the real world while balancing performance, cost, and compliance. An EPC designing for a Power Purchase Agreement (PPA) has different financial drivers than a residential installer maximizing a homeowner's ROI, but the technical principles are the same.

    Every design boils down to a few key decisions:



    • Module Selection: Do you specify Tier 1 modules for their bankability and robust warranties, or can you meet budget targets with Tier 2 panels where the performance trade-off is acceptable for the application?
    • Inverter Sizing: Correctly matching an inverter from a brand like Fronius or Sungrow to the array's voltage and current is critical. Undersizing clips production; oversizing wastes capital.
    • Storage Integration: If energy storage is specified, the design must seamlessly integrate solutions from manufacturers like BYD or FranklinWH, ensuring full compatibility and adherence to NEC Article 706 for battery systems.



    Pro Tip for Installers: The best designs are optimized for labor efficiency, not just peak kilowatt-hours. Planning conduit runs, inverter placement, and panel layout with your crew in mind can dramatically reduce installation time, boosting your bottom line on every job.

    The Critical Role of Structural and Electrical Evaluation



    A solar array adds a continuous dead load to a roof—typically 2.5 to 5 pounds per square foot. A stamped structural engineering review is not optional; it’s a mandatory step to verify the roof can handle the array’s weight plus any live loads from snow or wind. Skipping this exposes you to catastrophic liability.

    The electrical evaluation is equally vital. You must verify the main service panel has both the physical space and the busbar capacity for a new solar back-feed breaker. The NEC has a strict rule: the sum of the solar breaker and the main breaker cannot exceed 120% of the busbar’s rating. Exceeding this limit requires a panel upgrade or a line-side tap—both of which add significant cost and time. This must be identified during the initial site visit.

    For a deeper technical dive, our guide to solar energy system components breaks down how these pieces fit together. Meticulous planning here ensures your installation crew executes a vetted, code-compliant plan—no guesswork, no on-site change orders.


    Key Decision Points in Site Assessment & Design



    Making the right calls during this phase is crucial. This table breaks down the most critical factors for installers, EPCs, and developers to keep a project on track and profitable.



    Assessment Factor Key Consideration for Installers Impact for EPCs & Developers Recommended Action
    Roof Condition Is the roofing material nearing its end-of-life? A re-roof adds significant cost and coordination. Determines long-term asset viability and impacts O&M costs in PPA models. Conduct a thorough roof inspection. Factor re-roofing costs into the initial quote if the roof has less than 10-15 years of life remaining.
    Shading Analysis Which specific areas of the roof will have the highest solar irradiance throughout the year? Production estimates must be highly accurate to meet PPA performance guarantees and secure financing. Use tools like Solar Pathfinder or Aurora Solar to generate a detailed shade report. Adjust panel layout to minimize shading losses.
    Electrical Service Does the main panel have the capacity for the solar back-feed breaker per the NEC 120% rule? An unexpected service upgrade can severely impact project economics and interconnection timelines. Perform a full electrical service assessment, including photos of the panel interior and busbar rating, during the initial site visit.
    Structural Integrity Can the existing roof structure support the added dead load of the solar array? Structural upgrades can be a major unforeseen expense, jeopardizing the project's financial model. Require a stamped structural engineering letter for all projects to verify load capacity and attachment point specifications.

    Navigating Permits and Procurement Logistics



    Managing paperwork and the supply chain is as critical as turning wrenches. A perfect design and an elite crew are useless if you're stuck in permitting with the Authority Having Jurisdiction (AHJ) or your panels are delayed by six weeks due to supply chain disruptions. This phase is where projects are won or lost on administrative execution and logistical planning.

    The permitting process is the first major bottleneck. Every municipality has its own unique rules, submission portals, and review timelines. A flawed submission can trigger expensive redesigns and derail your entire project schedule, creating crew downtime and destroying profitability.

    This flowchart breaks down the critical path, from permit submission to ensuring your equipment is on-site and ready for installation.

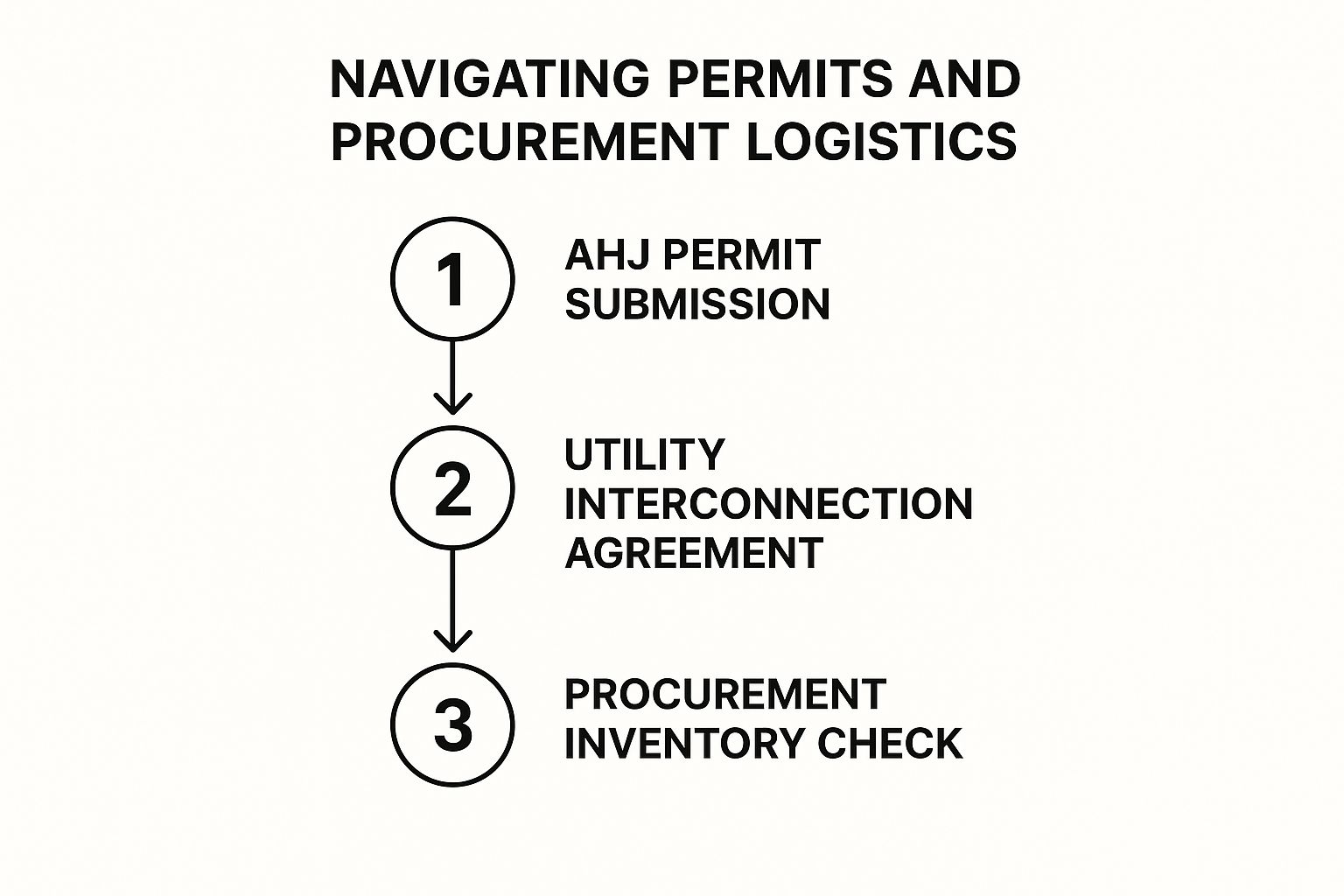

    Infographic showing the three key steps in navigating permits and procurement: AHJ Permit Submission, Utility Interconnection Agreement, and Procurement Inventory Check, connected by directional arrows.



    These are not sequential tasks; they must be managed in parallel. A delay in one stage creates a domino effect, which is why proactive management is essential.

    De-Risking the Permitting Process



    To avoid rejection, your permit package must be flawless. A single missing detail on a one-line diagram or an incorrect spec sheet can send your application to the back of the line. Your submission is proof of your professionalism and commitment to building to code, adhering to standards like the National Electrical Code (NEC).

    Your complete permit package must include:



    • Detailed Site Plan: Showing property lines, roof layout, and precise placement of all panels, inverters, and disconnects.
    • One-Line and Three-Line Electrical Diagrams: Clearly mapping the system's wiring from the modules to the point of interconnection.
    • Structural Engineering Letters: A stamped letter from a licensed engineer verifying the roof's load-bearing capacity.
    • Equipment Spec Sheets: Official manufacturer datasheets for all key components: panels, inverters (like Sungrow or Fronius), racking, and any energy storage systems.



    While managing the AHJ, you must simultaneously navigate the utility interconnection agreement. This is a separate process where the utility approves your design to ensure grid stability. Their review can take weeks or months; submit this application the moment your design is finalized.

    Mastering Procurement and Supply Chain Realities



    With permits in process, your focus shifts to procurement. The goal is simple: get all materials to the job site exactly when needed. Too early, and you have thousands of dollars of equipment sitting unprotected. Too late, and your crew is standing idle, costing you money.

    This is why your choice of distributor is a strategic decision. Partnering with a supplier that provides real-time, in-stock inventory visibility and firm lead times is a game-changer. It allows you to schedule crews with confidence, knowing your equipment will arrive on time.



    For Procurement & Project Managers: The true cost of procurement isn't the invoice price; it's the hidden cost of project delays, crew downtime, and liquidated damages from an unreliable supply chain. Look for a partner offering services like bundled freight, which combines components into a single, coordinated delivery, simplifying logistics and reducing risk. For a deeper dive, read about understanding the fundamentals of supply chain management.



    Relying on distributors with vague "4-6 weeks" lead times is a recipe for disaster in a volatile market. To better manage these challenges, review our guide on supply chain disruption management. Proactive planning and a transparent supply partner are your best defenses against project delays.

    Executing a Flawless On-Site Installation



    A team of solar panel installers securing panels onto a rooftop racking system.



    This is where planning meets execution. All the designs, permits, and purchase orders materialize as your crew transforms components into a power-generating asset. On-site installation is a disciplined process of mechanical and electrical work where safety, precision, and code compliance are non-negotiable. Every action directly impacts the system's performance, longevity, and ability to pass inspection. One shortcut can lead to a failed inspection, a safety hazard, or a chronically underperforming system.


    Mechanical Assembly: Racking and Panels



    The first order of business on any site is safety. This means establishing fall protection, securing the work area, and ensuring 100% PPE compliance. A safe site is an efficient site. Investing in processes for maintaining site safety during construction is critical.

    With the site secured, the crew begins laying out the racking system, translating the engineering plan into a physical structure.



    • Attachment Points: Locating and marking rafters is mission-critical. Each penetration must be drilled precisely and sealed with high-quality sealant to prevent water intrusion—a rookie mistake that leads to catastrophic roof leaks.
    • Rail Installation: Rails must be installed perfectly level and square. Misaligned rails put uneven stress on modules and are a clear sign of unprofessional work.
    • Module Mounting: Solar panels are lifted and secured using clamps torqued to the manufacturer’s exact specifications. Over-torquing can damage the panel frame; under-torquing can result in a panel becoming a projectile in high winds.



    Compliance Watchout: NEC 110.3(B) This code requires that all equipment be installed according to the manufacturer's instructions. Using the wrong clamps for a racking system or failing to follow torque specifications is a direct code violation that will guarantee a failed inspection.



    The racking is the backbone of the array. For a deeper look at the available options, see our guide on solar panel racking systems.


    Critical Electrical Wiring and Integration



    With panels mounted, the crew transitions to the electrical work. This is where individual components are integrated into a single, power-generating system. Precision is paramount; faulty wiring is a leading cause of underperformance and a serious fire risk.

    The process begins at the array, where panels are wired into series "strings" to build voltage. These strings are then combined in parallel to increase current. Meticulous wire management is essential to prevent abrasion and damage over the system's 25-year lifespan.

    Next, conduit is run from the roof to the inverter location. A clean, efficient conduit run minimizes voltage drop, maximizing energy harvest. The inverter—whether a string inverter from Fronius or a hybrid from Sungrow—is the system's brain and must be mounted and wired according to strict NEC rules for grounding, overcurrent protection, and clearance.

    The final step is the interconnection with the building's main electrical panel and any battery storage systems, such as units from BYD or FranklinWH. This complex work must be performed by a licensed electrician to ensure safety and code compliance.



    Compliance Watchout: NEC 690.12 Rapid shutdown is a mandatory life-safety requirement to protect first responders. The system must have a reliable method to de-energize the array quickly. Failure to install and test the rapid shutdown device correctly is an automatic inspection fail.

    Passing Inspection and Commissioning the System





    This is the final validation phase. The last panel is secured, and the final wire is pulled. Now, your work is put under the microscope to prove the system is safe, code-compliant, and ready to perform for the next 25 years. A smooth inspection and commissioning process is the hallmark of a professional operator, avoiding costly punch-lists and delays that erode profitability.

    The Final Inspection Gauntlet



    Two key inspections stand between your completed installation and a Permission to Operate (PTO): one from the local AHJ and another from the utility. These are not formalities; inspectors are trained to spot shortcuts and safety violations.

    The AHJ inspector is focused on electrical and structural safety, comparing your work against the approved plans and the latest National Electrical Code.

    Here’s a quick rundown of their checklist:



    • Proper Grounding and Bonding: They will verify a continuous ground path from every module and rack component back to the grounding electrode system.
    • Correct Signage and Placards: All required warning labels must be correctly placed on disconnects, inverters, and the main service panel per NEC requirements.
    • Code-Compliant Wiring Methods: They will inspect conduit fill, wire management under the array, and the workmanship of connections in junction boxes.
    • Rapid Shutdown Functionality: A failed rapid shutdown test is an instant fail. They will verify the system de-energizes as required by NEC 690.12



    The utility inspector’s primary concern is grid interconnection. They will verify the AC disconnect is accessible, properly labeled, and that inverter settings match their requirements to ensure grid stability.



    Pro Tip for Installers: Arrive at the inspection prepared. Have a binder with your approved plans, equipment spec sheets, and torque logs ready. Walk the inspector through the job calmly and professionally. A clean, organized site and a prepared contractor build immediate trust.

    System Commissioning: A Step-By-Step Protocol



    With green tags from both the AHJ and the utility, it’s time to commission the system. This is the methodical process of safely energizing and testing the equipment. Never just flip the breakers without following a strict sequence.

    Your standard commissioning checklist must include:



    1. Verify All Connections: Double-check that all DC and AC connections are torqued to manufacturer specifications.
    2. Insulation Resistance Test: Use a megohmmeter to test the DC conductors for faults or ground shorts before energizing.
    3. Voltage and Polarity Checks: Use a multimeter to confirm the open-circuit voltage (Voc) of each string is within the inverter’s operational range and that polarity is correct.
    4. AC Voltage Verification: Confirm stable and correct AC voltage at the point of connection.
    5. System Energization: Follow the inverter manufacturer's startup procedure precisely, typically energizing the AC disconnect first, followed by the DC disconnect.
    6. Performance Verification: Once the inverter syncs to the grid, monitor its output to ensure production data is logical for current weather conditions and that all strings are performing as expected.

    Professional Project Handover



    The final step is the client handover. A professional handover builds trust and reduces future service calls. Provide a comprehensive folder with all essential documents.

    This package must include:



    • As-Built Diagrams: Final electrical drawings showing the installed system.
    • Warranty Information: All manufacturer warranty documents for panels, inverters, and batteries.
    • Owner’s Manual: A simple guide on system monitoring and basic troubleshooting.
    • Contact Information: Clear details for service, support, and warranty claims.



    Global solar capacity soared past 2.2 terawatts (TW) by the end of 2024, with over 600 GW commissioned that year alone. While regional codes vary, the core principles of a safe, professional commissioning process are universal. You can read more about these global solar market trends driving this incredible growth.



    Common Questions About the Installation Process



    Even the best-laid plans encounter challenges. Here are straight answers to the most common questions from installers, developers, and project owners.



    How Long Does a Full Installation Really Take?



    While the on-site work for a residential system may only take one to three days, the true project timeline from contract to Permission to Operate (PTO) is much longer. The delays are almost always administrative, not operational.

    A realistic project timeline includes:



    • Design & Engineering: 1-2 weeks
    • Permitting (AHJ & Utility): 3 weeks to 3+ months (the biggest variable)
    • Equipment Procurement & Delivery: 1-4 weeks (highly dependent on supply chain)
    • On-Site Installation: 1-3 days (residential)
    • Final Inspections & PTO: 2-6 weeks



    A typical residential project takes two to four months from start to finish. Commercial projects have significantly longer timelines due to more complex engineering and permitting requirements.

    What Are the Most Common Project Delays?



    Project delays directly impact cash flow and profitability. The most significant delays occur before a single tool is unboxed.



    Expert Insight: The vast majority of solar project delays are administrative. The primary culprits are slow AHJ permit reviews and lagging utility interconnection approvals. A single error on a plan set can send you to the back of the queue, adding weeks or even months to your timeline.



    Other common project killers include:



    • Supply Chain Snags: Backordered panels, inverters, or specialty components can halt a project indefinitely.
    • Surprise Site Conditions: Discovering the need for a structural upgrade or a main service panel replacement during installation is a costly and time-consuming setback.
    • Failed Inspections: A failed inspection requires rework, rescheduling, and re-inspection, creating a cascade of delays.

    What Are the Key Cost Factors in an Installation?



    The final project cost is driven by more than just hardware. Understanding these variables is critical for accurate quoting and project management. In 2024, global solar electricity generation grew by an estimated 28%, reflecting the massive investment in labor and materials behind every installation. You can get a deeper look at this global solar boom on utilitydive.com.

    The primary cost drivers are:



    • System Size & Equipment Tier: A larger system using premium Tier 1 modules and a high-efficiency inverter carries a higher upfront cost.
    • Roof Complexity: Steep pitches, multiple roof faces, and obstructions significantly increase labor hours and material costs for specialized racking.
    • Electrical Work: The need for a main service panel upgrade, trenching, or long conduit runs can add thousands to the project cost.
    • Labor and Permitting Fees: These "soft costs" are a major budget component and vary significantly by region.



    Navigating the complexities of a solar installation requires a partner who understands the realities of the field. At PES Supply, we provide the in-stock inventory, logistical expertise, and technical support to keep your projects on schedule and on budget.

    Request a Quote Today

    Related Resources:

    Calculate how much storage you need with our battery sizing calculator.

    Check solar incentives available in your state.

    Use our free solar system calculator to size your array.

    Check out our Solar Panel Comparison Tool. Check out our Inverter Sizing Calculator.

    Calculate your solar payback and 25-year savings with our Solar ROI Calculator. Follow our complete DIY solar installation guide for step-by-step instructions. Keep your system running at peak performance with our Solar Maintenance Guide.

    Related Resources

    Need Help Sizing This?

    Our team can help you calculate loads, select the right equipment, and source everything from one PO.

    📞 (502) 790-0600

    Email Our Team
    Solar Panels Generators Batteries / ESS EV Chargers Circuit Breakers Charge Controllers

    One PO. One Invoice. Every Trade Covered.

    PES Supply is the distribution arm of PES Global Group — 50,000+ SKUs from 169 authorized brands, LTL freight shipping from Louisville, KY.

    Get a Quote
    Share: X f in @

    Related Articles

    Solar panel modules stacked at a U.S. port facility with customs documentation overlay, representing Section 232 tariff compliance for solar imports

    Section 232 Solar Tariffs & Minimum Import Prices: The De...

    Aug 14, 2026
    Close-up of an electrical breaker panel with a licensed electrician testing circuits with a multimeter

    How to Size Circuit Breakers: NEC 125% Rule (2026)

    Aug 12, 2026
    Container port at golden hour with crane lifting crated solar panels over the dock

    Solar Module Sourcing in 2026: Regional Costs, Tariff Sta...

    Aug 09, 2026
    Pallets of stacked solar modules in a bright distribution warehouse with forklift and conduit racks

    Module Prices Hit $0.34/W — So Why Did Your Commercial Qu...

    Aug 08, 2026
    Two installers finishing a residential rooftop solar installation at sunset

    The Safe Harbor Deadline Passed. Here's What Actually Hap...

    Aug 07, 2026
    Worker in cleanroom suit inspecting a silicon ingot at a solar polysilicon factory, shipping containers beyond the window

    Section 232 Polysilicon Tariffs Hit Solar: What August 20...

    Aug 06, 2026
    Technician's hands with clipboard and tablet inspecting a home standby generator, shallow depth of field

    Generac Generator Warranty Explained: 5, 7, and 10-Year E...

    Aug 03, 2026
    Residential standby generator installed beside a modern suburban home's electrical service panel at golden hour

    Whole Home Generator Sizing Guide 2026: How Many kW Do Yo...

    Aug 03, 2026
    Wall-mounted home battery storage unit installed in a garage beside a solar inverter

    Battery Storage Incentives by State: 2026 Rebate Programs...

    Jul 30, 2026
    Rows of solar panels in a distribution warehouse, tied to 2026 supply and pricing trends

    Solar Market Outlook H2 2026: Panel Prices, Supply Chain,...

    Jul 29, 2026
    Imported solar panels in shipping crates at a port, subject of 2026 tariff updates

    Solar Industry Tariff Updates: What Installers Need to Kn...

    Jul 27, 2026
    A city skyline at dusk with glowing windows and power transmission lines in the foreground

    Growing Electricity Demand: Why Energy Policy Reform Is M...

    Jul 24, 2026
    A technician installing a wall-mounted mini-split heat pump indoor unit in a bright modern living room

    Mini Split Installation Cost (2026): Equipment, Labor & E...

    Jul 23, 2026
    Solar panels elevated over green farmland with sheep grazing beneath

    Harnessing the Sun and Soil: How Agrivoltaics is Revoluti...

    Jul 21, 2026
    A showroom display of several brand-new black solar panel models angled on stands

    Newest Solar Panels in 2026: Latest Models from Leading U...

    Jul 18, 2026
    From the Field: A Master Electrician's Guide to Solar Commissioning

    From the Field: A Master Electrician's Guide to Solar Com...

    Jul 15, 2026
    A home energy storage system with a smart meter showing zero grid flow

    How Can a Residential ESS Achieve 0W Grid Flow?

    Jul 14, 2026
    Close-up of an automatic transfer switch panel with conduit in a residential utility room

    How Automatic Transfer Switches Work

    Jul 12, 2026
    A large residential rooftop fully covered with solar panels on a sunny day

    Solar Panels for 10,000 kWh/Month: 2026 Sizing Guide

    Jul 06, 2026
    A 26kW standby generator on a concrete pad beside a two-story suburban home at dusk

    26kW Generator Guide 2026: Generac Review, Amps, What It ...

    Jul 01, 2026
    7 Benefits of Switching to Commercial Solar Energy

    7 Benefits of Switching to Commercial Solar Energy

    Jun 30, 2026
    2026 H1 Solar Industry Recap: Record Installations, Tariff Uncertainty, and Storage Dominance

    2026 H1 Solar Industry Recap: Record Installations, Tarif...

    Jun 30, 2026
    How to Successfully Implement Solar Energy in Your Business

    How to Successfully Implement Solar Energy in Your Business

    Jun 30, 2026
    Three different solar panel types displayed side by side on stands outdoors

    The Main Types of Solar Panels: Which Should You Choose?

    Jun 26, 2026
    After Nearly 20 Years, America's Biggest Clean Energy Project Is Finally Operational

    America's Largest Clean Energy Project Goes Live After Ne...

    Jun 26, 2026
    Procurement Strategy: How to Navigate Solar Equipment Sourcing in 2026

    Procurement Strategy: How to Navigate Solar Equipment Sou...

    Jun 15, 2026
    A friendly solar consultant shaking hands with a homeowner on a sunny driveway

    How to Find Local Solar Companies Near Me

    Jun 14, 2026
    How Long Do Solar Panels Last? (2026 Guide)

    How Long Do Solar Panels Last? (2026 Guide)

    Jun 14, 2026
    A homeowner in conversation with a solar consultant on a sunny driveway

    What Questions Should I Ask My Solar Company?

    Jun 14, 2026
    A homeowner on the porch of a solar-equipped suburban home reviewing an energy bill

    Is Solar Worth It for My Home?

    Jun 10, 2026
    A homeowner and contractor reviewing permit paperwork on a clipboard in front of a house with new solar panels

    What Are Solar Permits and How Long Do They Take?

    Jun 07, 2026
    A homeowner at a kitchen table with a calculator and solar quotes

    Solar Panel Cost in 2026: What You'll Actually Pay

    Jun 06, 2026
    How Much Money Can I Save With Solar Panels?

    Solar Panel Savings in 2026: Real Numbers by State

    May 30, 2026
    The New York State Capitol area skyline with rooftop solar installations in the foreground

    New York Boosts Solar Investment in 2027 State Budget

    May 29, 2026
    A compact modular microinverter unit being mounted beneath rooftop solar panels by an installer

    Mango Power modular microinverter hits US residential sol...

    May 29, 2026
    A futuristic solar panel manufacturing facility with robotic arms and rows of new modules

    How Tesla Plans to Scale Solar Production to 100GW by 2028

    May 25, 2026
    A vast Australian solar farm with rows of panels and large battery storage containers

    NSW Seeks 2.5 GW Renewable Capacity, 12 GWh Storage Under...

    May 21, 2026
    Solar Workforce Crisis 2026: Installer Shortage, Training Programs, and Electrician Demand

    Solar Workforce Crisis 2026: Installer Shortage, Training...

    May 15, 2026
    Cows grazing in a green alpine pasture beneath elevated solar panels

    Nestlé Launches Agri-PV “Cow Solar” Project in Allgäu, Bl...

    May 04, 2026
    A row of suburban homes with rooftop solar and small battery cabinets

    FranklinWH Systems to Launch First U.S. City-Owned Reside...

    May 01, 2026
    Three sleek white home battery units wall-mounted in a row in a modern garage

    Tesla Expands Energy Solutions with Three-Phase Powerwall 3P

    Apr 26, 2026
    Solar panel canopies over a California school campus parking lot

    School District in California Deploys 3.1 MW Solar System...

    Apr 14, 2026
    The Future of Solar: 7 Breakthrough Technology Trends in 2026 — Portlandia Electric Supply

    The Future of Solar: 7 Breakthrough Technology Trends in ...

    Apr 12, 2026
    Trainees in safety vests learning solar panel installation at a training facility

    New York Boosts Renewable Workforce Funding with $50 Mill...

    Apr 05, 2026
    Pallets of wholesale solar panels stacked in a warehouse for EPC and installer buyers

    Wholesale Solar Panels: The Complete B2B Procurement Guid...

    Mar 13, 2026
    A large-format bifacial solar panel tilted on a rack at a test yard

    Jinko JKM580N-72HL4-BDV 580W N‑Type TOPCon Bifacial Panel...

    Mar 11, 2026
    Briggs and Stratton 100kW natural gas standby generator 120 240V three-phase outdoor commercial unit by Portlandia Electric Supply

    Briggs & Stratton 100kW Natural Gas Standby Generator (12...

    Mar 06, 2026
    22kW Generator Buying Guide: How to Choose the Right Power Solution

    22kW Generator Buying Guide: How to Choose the Right Powe...

    Mar 02, 2026
    APSystems QS1: The Complete Buyers Guide to Features, Installation, and Performance

    APSystems QS1: The Complete Buyers Guide to Features, Ins...

    Mar 01, 2026
    The Complete Guide to the ATESS HPS100-US-220D 100kW Hybrid Inverter With Integrated Transformer — Portlandia Electric Supply

    The Complete Guide to the ATESS HPS100-US-220D 100kW Hybr...

    Feb 25, 2026

    Get Price Drops & Product Releases

    Weekly digest for installers and project managers — price drops, new stock, NEC code updates.

    PES Supply, a PES Global Group Company
